Is the Capacity Real? Verifying a Pet Toy Factory's Output Claims

April 21, 2026 Audit & QC About 12 min read TOYORIGIN Sourcing Team

Key Takeaways

  • Capacity is the one sourcing number that tends to grow when you ask twice. Treat every quoted figure as a hypothesis, not a fact.
  • Rebuild the claim with arithmetic: machines times output per machine-shift times utilization. The composition by product family matters more than the total.
  • Cross-check with five pieces of evidence: schedule board, piecework payroll, material inbound, a named machine list, shipping records.
  • Peak season is where capacity claims break — ask "whose lines, which week," not just "how many per month."
  • Bind what you verified into the PO: named lines, weekly output commitment, reorder priority, and the right to verify by unannounced video check.

Factory capacity is the one number in sourcing that grows when you ask twice. A first inquiry returns "one million pieces a month"; a polite follow-up before a large order returns "one and a half, and more in peak." Nothing physical changed in between — only the size of the order being courted. Buyers who accept the first figure usually discover the truth in the worst possible way: a confirmed order that slips in October, when every factory is triaging its customers and the newest names are triaged first. This article lays out a verification method that fits in an email thread: an arithmetic frame, five pieces of cross-evidence, the peak-season traps, and the contract language that keeps a verified number honest.

Start With the Arithmetic

Real capacity decomposes. The frame is machines (or lines) times output per machine-shift times utilization, stated per product family — because a plush line and an injection line produce different things at different rates, and only the composition tells you whether your order fits. A worked example, using our own published configuration: eight partner lines — three plush sewing, three injection and vulcanizing, one rope braiding, one packing — supporting a stated monthly output of 1.5 million-plus pieces, of which roughly 600 thousand is plush, 500 thousand rubber and TPR, and 400 thousand rope and woven goods.

The composition is the part most quotes omit, and it is the part that matters. A factory claiming two million monthly units that owns no vulcanizing presses cannot make your rubber chew toys, no matter what the total says. So when a supplier quotes a number, ask the follow-up that matters: of that total, how much is plush, how much rubber or plastic, how much rope — and on how many named lines? A supplier who answers in product families is usually describing a real floor; a supplier who repeats the total is describing a brochure.

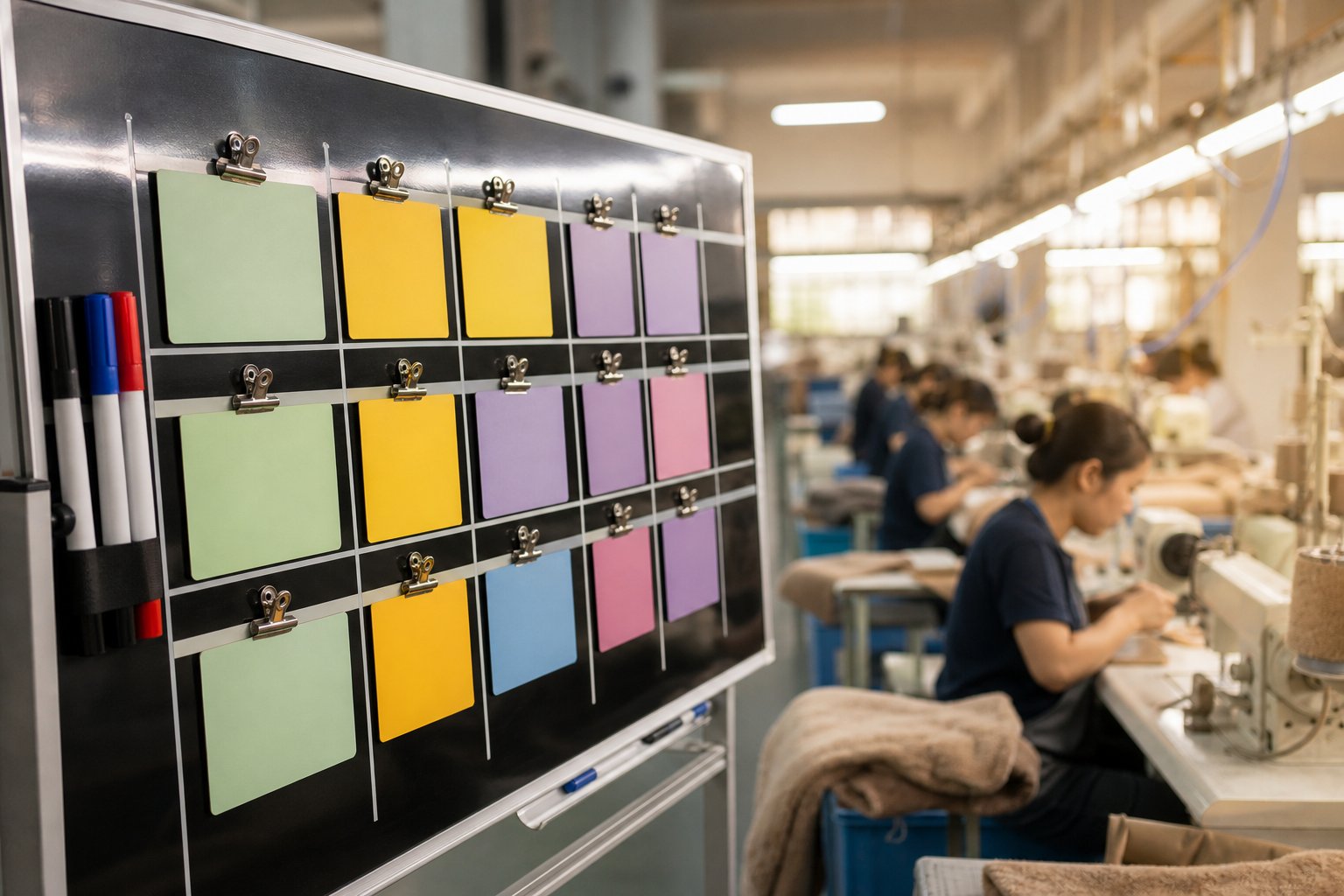

Close-up of a production schedule board with planning cards above a workshop floor
The schedule board is the single best cross-check: it shows whose orders actually occupy the lines this week.

Five Pieces of Evidence to Cross-Check

Arithmetic gives you the shape of a plausible number; evidence gives you its weight. Five documents, none of them confidential once an order is under discussion, separate a working floor from a projected one:

EvidenceWhat it showsHow to request it
Production schedule boardWhich orders occupy which lines, this week and nextSame-day photo during a video call — a staged photo will not carry a date
Piecework payroll summariesActual labor hours and units by weekSummary totals only, no names; ask for a three-month trend
Material inbound ledgerFabric, compound and component volumes arrivingMonthly totals against claimed output; inputs must precede outputs
Machine inventoryMachine counts by type, with names and approximate ageA list with line assignments — leased or idle machines disclosed
Shipping recordsWhat actually left the gate recentlyBill-of-lading counts or forwarder booking summaries per month

No single document is conclusive; payroll can be padded and boards can be dressed. But five independent streams are hard to fake coherently — an inflated board collapses against inbound materials and outbound bookings, and that collision is exactly what you are looking for.

The Peak-Season Shell Game

The most common failure is not a lie but a subtraction. The lines being quoted exist, and the monthly figure is even true — in February. By the time your Q4 order lands, the same lines are committed to the customers who ordered first, and capacity quietly becomes a queue. So the peak-season question is never "how many per month" but "whose lines, which week." Practical tells: ask which weeks in September to November are already committed and what share of them your order would hold; ask whether your reorder would wait behind new customers; and weigh quoted lead times against the claim — a factory promising 25–35 day production in a season when everyone else quotes longer is either better organized or better at adjectives. Stock programs are the honest exception: if 1,200-plus SKUs sit ready for private label and dispatch in 5–10 days, the capacity question shifts from the line to the warehouse — and the warehouse is far easier to verify.

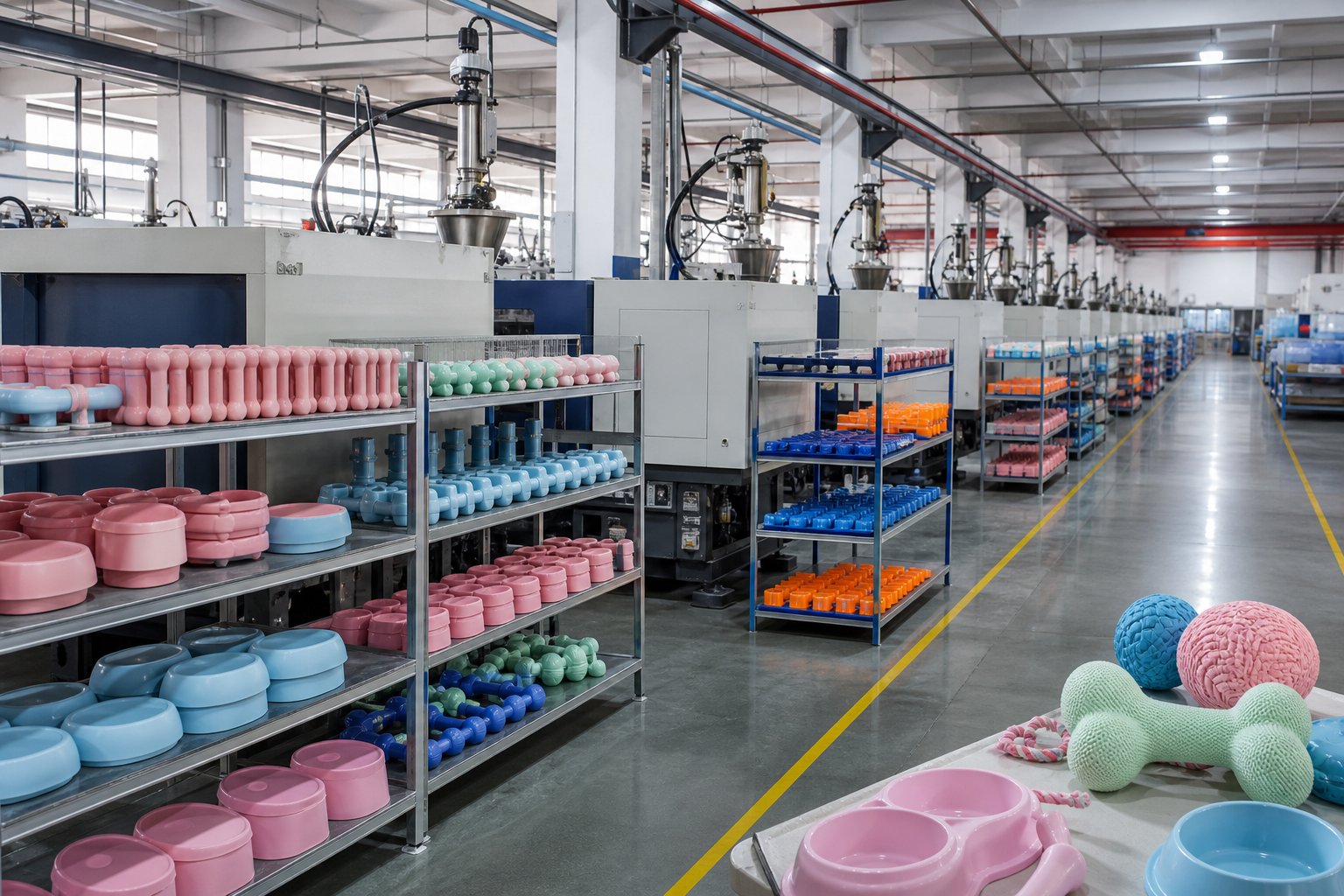

Wide view of an orderly injection workshop with machines running in sequence
An injection floor running in sequence at mid-morning — the most informative hour for a capacity visit.

Red Flags in the First Call

Between the first email and the first video call, capacity fiction announces itself in patterns worth memorizing:

  • The number arrives before your specification does. Real capacity questions start with what you are making.
  • The unit is a group: "our group has twelve factories." You are booking one floor, not a federation.
  • Live video during production hours is deflected toward the sample room. Sample rooms are showrooms; the floor is the fact.
  • The machine list includes idle or leased equipment without saying so.
  • No named line is offered for your order — your production is a someday concept, not a slot.

Any one of these has an innocent explanation. Three of them together describe a supplier who is selling you someone else's capacity, which is the subject our piece on factory versus trading company tells picks apart in detail.

Verification note: remember whose capacity you are actually buying. In industrial-belt sourcing, a trading desk will quote belt-wide numbers that no single factory honors; the purchase order, however, binds one legal entity. Ask exactly which entity signs, which lines it owns or controls under contract, and what happens to your order if those lines are reassigned — and fold the answer into the contract, not into the email thread.

Put the Verified Number in the Contract

Verification only pays once it is written down. Four clauses convert a checked claim into an enforceable one, and mature factories accept them without drama: your order runs on named lines; the supplier commits a weekly output against those lines; reorders from you carry a priority window ahead of new customers; and late delivery carries a remedy that scales with the delay. Add the quiet one that keeps everyone honest — the right to verify by unannounced video check during production hours. Factories that run real floors do not fear the camera; the ones that negotiate hardest against these clauses are telling you, in advance, which number was never real. For the walk-through method that pairs with this, see our plush factory audit guide, and for the fixed numbers we publish about our own floor, see the factory page.

Frequently Asked Questions

How can I sanity-check a factory's capacity claim?
Rebuild the number from arithmetic and cross-evidence. Machines times output per machine-shift times utilization gives an order of magnitude; then test it against a same-day photo of the production schedule board, piecework payroll summaries, raw-material inbound ledgers, a named machine inventory and recent shipping records. A real capacity survives all five checks; an invented one rarely survives two.
Why do pet toy factories inflate capacity figures?
Three reasons dominate: quotes are written to win the RFQ, peak-season commitments already consume the lines being quoted, and group or belt-wide capacity gets presented as the factory's own. The buyer pays for the gap as delayed shipments, rushed QC or an order quietly moved to a subcontractor.
Can I verify capacity without visiting the factory?
Yes, mostly. Ask for a live video call during production hours showing your intended lines, a same-day photo of the schedule board, and evidence documents. A third-party inspection visit can confirm machine counts and working lines when an order is at stake.
What capacity clauses belong in the purchase order?
Name the production lines that will run your order, commit a weekly output figure, give reorders a priority window, attach a remedy for late delivery, and reserve the right to verify by unannounced video check during production. Capacity you cannot verify is capacity you are renting, not buying.

Need a floor you can verify, not a number you must hope for?

Send your volume by product family — we reply with the named lines, the monthly output behind them and FOB ranges per tier.
